Cunderdin Hybrid Solar PV + Battery

We pay our respect to Elders, past and present, and extend that respect toall Aboriginal and Torres Strait Islander peoples

Project data

Technology

52 wind turbines

V136 – 4.2 MW Vestas

180 m blade tip height

Total installed capacity

218.4MW

Location

16.5 km north west of Port Fairy

4.6 km north east of Yambuk

Land

Approximately 3,388 hectares

Primarily agricultural activities (grazing of sheep and cattle)

10 wind farm host landowners

10 transmission line host landowners

Connection

Victoria electricity grid via a 24 km 132 kV

overhead transmission circuit to the existing 500 kV

Tarrone Terminal Station

Energy, capacity & LGCs

Snowy Hydro

Contractors

Vestas Australia Wind Technology (turbines and O&M)

Decmil Australia / RJE Global (civil and electrical)

Transmission Network Operator

AusNet

Project benefits

656,000 CO2 tons of emissions avoided
51,000 households to be supplied with clean energy
100 full time equivalent jobs created during construction
6 long term jobs during operations for the life of the project
$229,000 invested in community engagement and benefit sharing

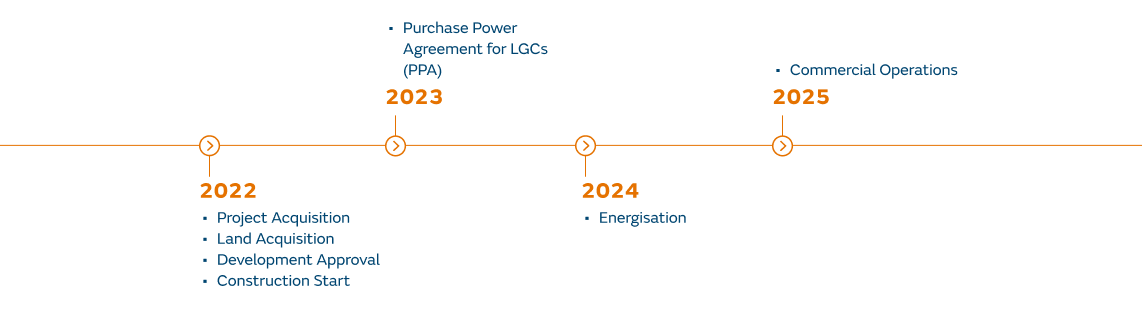

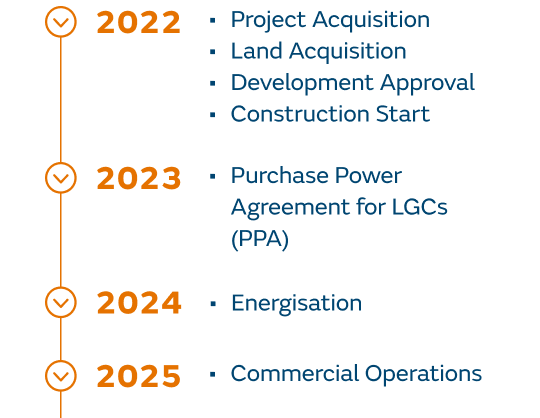

Project timeline
